Charleston at the Crossroads

Three UDOT Projects Are Reshaping Our Town — Here's What's Actually Happening

For most Wasatch County residents, "the bypass" is a single project that's been debated for over two decades. But here in Charleston, we're in a unique position: three separate UDOT projects are converging on our town simultaneously, and two of them are already under construction.



If you live in Charleston, your commute, your property's relationship to traffic, and the long-term character of our community are being shaped right now by decisions on three different timelines. Here's a clear-eyed look at all three — and why Charleston specifically sits at the center of it all.

What's Actually Happening Right Now (2025–2027)

Project 1 — US-189 Widening: Wallsburg to Charleston

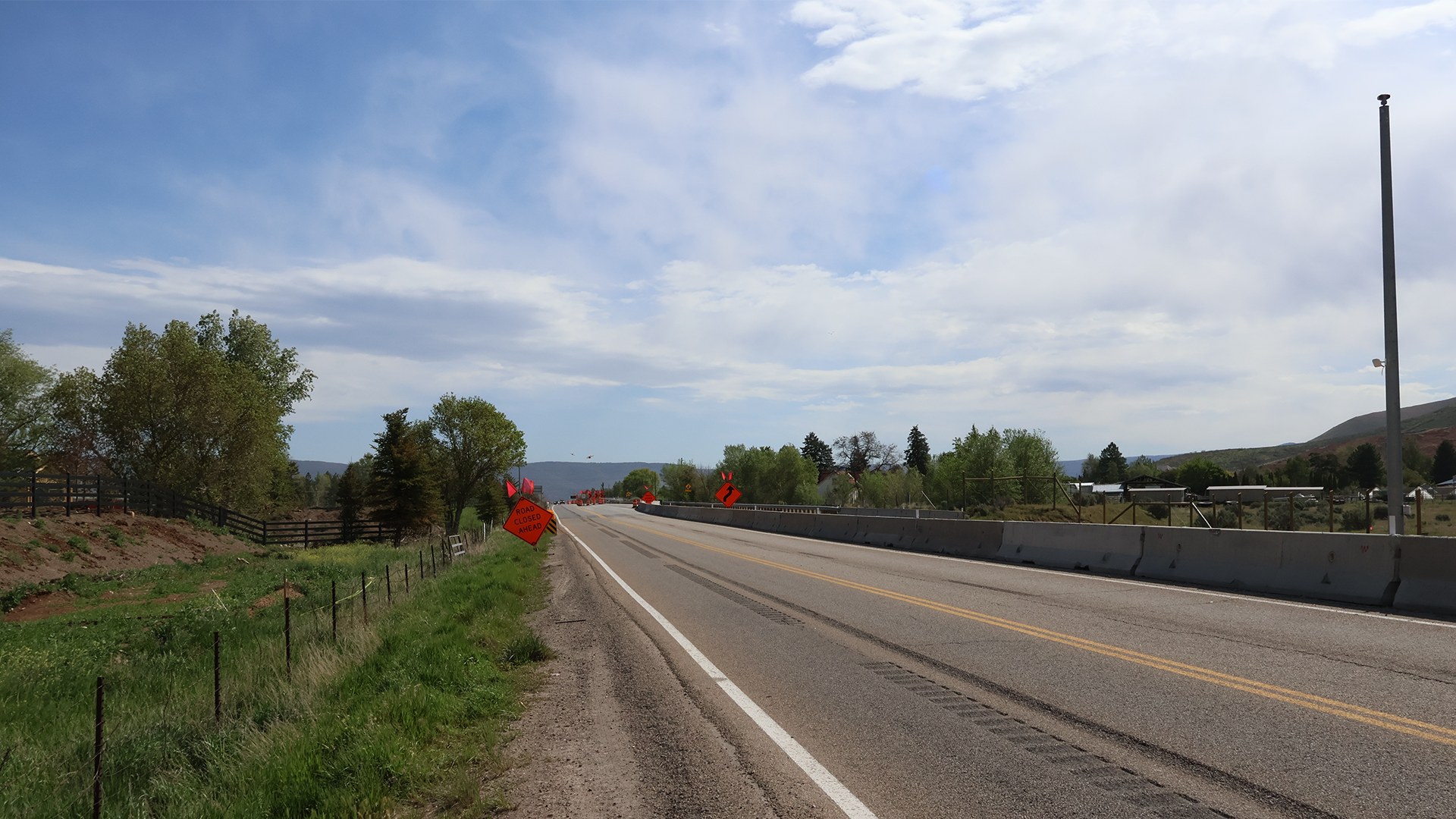

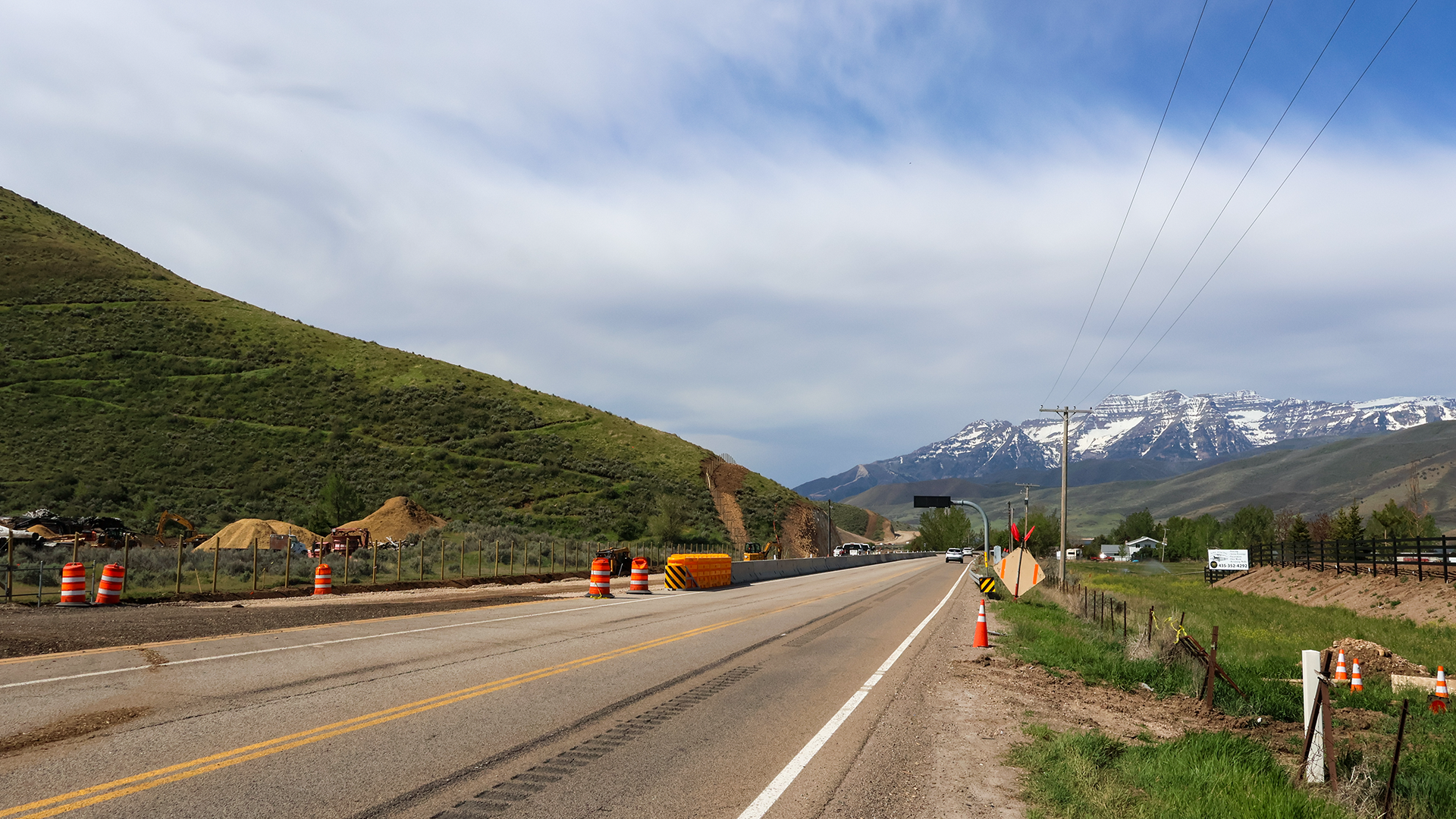

Status: Active construction. This is the project most likely to affect your daily drive over the next 18 months.

UDOT is doubling the capacity of US-189 between Wallsburg and Charleston by building two new lanes as an elevated split highway carved into the eastern hillside — similar to how Provo Canyon was widened. When complete, US-189 will have two lanes in each direction all the way from Provo to Heber City for the first time.


What's being built:

  • New traffic signal at the US-189 / SR-113 intersection, right at Charleston's edge
  • Realigned SR-113 connection with longer acceleration and deceleration lanes

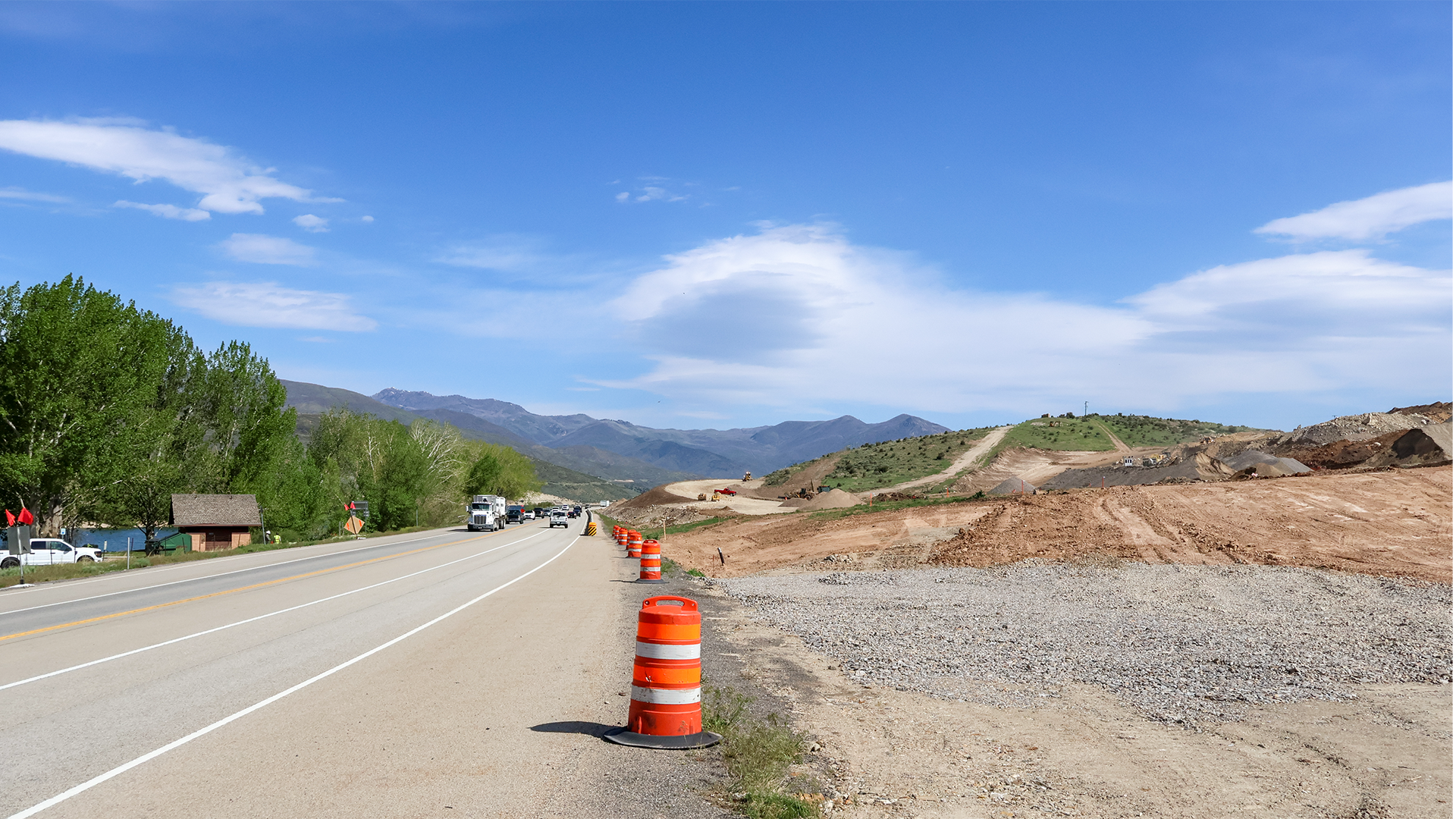

  • Improved access and parking at the Island Beach Day Use Area
  • Wildlife fencing along the corridor
  • Full pavement replacement on existing lanes


Timeline: Construction began October 2025. Southbound lane reconstruction runs Fall 2026 through Summer 2027. Full project completion expected fall 2027.


What it means for Charleston: Expect intermittent delays and lane shifts on 189 through 2027. The new SR-113 signal — currently being installed in the realignment work between 3600 South and Island Beach — will fundamentally change how you enter and exit Charleston from the south.

Project 2 — US-40 Widening: The Y to Center Creek


Status: Active construction.

UDOT is widening US-40 to five lanes (two in each direction plus a center turn lane) from the US-189 intersection up through Center Creek Road. New traffic signals are going in at 1500 South (built in 2025) and potentially at Center Creek Road or Mill Road during the 2026 construction season. Twelve-foot shoulders are being added throughout.


What it means for Charleston: This widens the road exactly where you connect from Charleston into Heber. Combined with the 189 work, both of Charleston's major arteries are simultaneously being rebuilt.

The Long-Term Project (2030s and Beyond)

Project 3 — The Heber Valley Corridor Bypass


Status: Draft EIS published. Final decision expected late 2026.

This is the big one — the project that's been deliberated for over twenty years and now has a preferred route.

UDOT published its Draft Environmental Impact Statement on January 7, 2026, identifying Alternative B as the preferred route at an estimated $760.5 million.


Alternative B starts at the Potter Lane / College Way intersection on US-40, cuts west across the North Fields, and reconnects with US-40 and US-189 south of downtown — right at Charleston's edge.


Where it stands now: The 60-day public comment period closed March 9, 2026, with approximately 700 comments received. Notably, all seven Wasatch County councilmembers, the Charleston mayor, the Midway mayor and council, and several Heber City officials signed a joint letter asking UDOT to consider shifting the highway closer to existing US-40 to minimize impact on the North Fields. UDOT will respond to substantive comments in the Final EIS.


Key design features:

  • Limited-access freeway-style road designed for 65 mph travel
  • Only three interchanges total: Potter Lane, SR-113, and south of the Y intersection
  • 8 property relocations under Alternative B (vs. 27 under Alternative A)
  • 2:1 wetland mitigation in the North Fields
  • Land protected in perpetuity — no commercial development, no future on-ramps


Timeline:

  • Final EIS and Record of Decision: expected late 2026
  • Construction funding: not currently programmed in the state's transportation budget through 2031
  • Earliest realistic groundbreaking: six or more years after the final decision

Why Charleston Sits at the Center of All Three


Look at a map. The Y intersection — where US-40 and US-189 meet at the southwest edge of Charleston — is the convergence point for every single one of these projects:

  • The southern terminus of the bypass
  • The eastern terminus of the 189 widening
  • The southern end of the US-40 widening


Charleston will be one of only three interchanges on the entire bypass corridor. That's a significant designation. It means that when these projects are complete, Charleston transitions from "the quieter town just past Heber" into a designated gateway point for regional traffic flowing in from Provo, Park City, and points east.



Whether that's good news or bad news depends on the property and the priorities. But it is a fundamental shift, and it's worth understanding now rather than later.

How Different Parts of Charleston Are Affected


The three projects affect Charleston unevenly:


  • Properties along SR-113 and 3600 South will feel the most direct construction impact over the next 18 months as the 189 / SR-113 intersection is rebuilt and the new signal goes in.
  • Properties near the Y intersection will see the biggest long-term character change once all three projects mature, with increased traffic capacity in every direction.
  • Properties in western Charleston facing the North Fields are the most affected by the bypass itself. One genuine upside: UDOT's commitment to limited access and permanent open-space protection actually prevents future commercial sprawl in that direction.
  • Properties in the interior of Charleston are largely insulated from direct impact and stand to benefit from reduced regional through-traffic once the bypass is operational.
  • A note on compensation: Utah law only authorizes direct compensation for landowners who experience right-of-way seizures. Indirect impacts — view changes, noise, traffic patterns — are not compensable under current state law.

What's Next on the Calendar


  • Through 2027 — Active construction on US-189 and US-40
  • Late 2026 — UDOT publishes the Final EIS and Record of Decision on the bypass
  • Ongoing — Federal review for water and environmental compliance
  • 2031 and later — Earliest possible bypass construction, contingent on funding

Official Resources
